LINKS SUPERINTENDENT’S REPORT
FOR DECEMBER 2011
WEATHER
December was a decent month certainly compared
to last year, generally cloudy, with winds again predominantly westerly. Gale force south westerly winds were
experienced on both the 8th and 28th of the month. Frosts were prevalent on 12 occasions and
average noon temperatures were near normal at 6.5° C. Total rainfall for the month was a little
below normal at 35mm.
December was a short month as usual due to
seasonal holidays in the final week and the courses were closed for two days
(20th and 21st) due to rain water lying over frozen
ground.
WORK ON THE LINKS
Championship Course
Fairway Top Dressing
Fairway top dressing continued
early in the month when fairways 2,3,5,7,9,10,14,16 and 17 were completed,
followed by the usual brushing in.
Aeration
Verti-drain aeration during the
month involved walkways and traffic routes using 1” solid tines while lower
lying fairway areas were verti-drained using ¾” solid tines. Greens were slit-tined towards the end of the
month.
Bunker Revetments

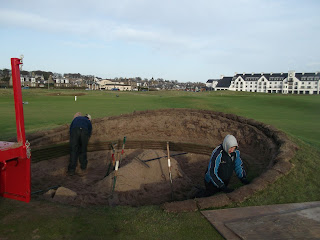

Bunker revetments during the month
included:-
1 at 6th green left
hand side
1 at 12th approach
left hand side
1 at front of green 13th
hole.
Grow covers were fitted to
certain new bunker faces where appropriate.
10th Fairway
Work was completed on the fairway
side of the burn on this hole with the raising of the lower flood prone section
close to the burn followed by returfing.
Minor Turf Repairs
A few minor turf repairs were
carried out during the month including the removal of disease scars on the 9th
and 13th greens.
Liquid Iron Treatment
Greens and green surrounds were
sprayed with liquid iron during the month.
17th Fairway Level
Adjustments
Following completion of turf
removal, silty soil excavation was carried out, while decent re-usable topsoil
was stock piled at the start of the fairway.
Sand was driven in to raise levels, particularly on the left side of the
work area. Sand was also required on the
right side of the fairway to match up to the raised burn wall (1 block). Following topsoil replacement and rotavation,
where required, and the usual firming, a cover of fresh root-zone was applied
over the area as needed. Raking over was
carried out in readiness for turfing over.
Irrigation System
The old (1985) irrigation water
storage tank was carefully dismantled following emptying. The concrete base was broken up and removed
and the underlying pipe work uncovered.
A new sewage waste pipe leading to the septic tank was installed. The fusion-welded
10” pipe connections from the remaining tank feeding the pump house are
scheduled for installation.
Miscellaneous
Miscellaneous jobs carried out
included greens rolling, re-shaping bunker sand, salting service roads, paths
and bridges and removing the fence round the turf nursery next to the practice
ground lake.
BURNSIDE COURSE
Bunker Revetments
Bunkers reveted during the month
included:-
6th fairway right hand
side (2)
7th greenside right
hand side (1)
3rd green front (1)
18th greenside right
hand side (2)
Burn Bank – 3rd
Hole
Turfing on the burn banking above
the stone filled gabions was completed early in the month and the boundary
fencing was replaced.
Bunker Infilling
The bunker on the 8th
fairway was infilled and turfed over as arranged during the month.
Aeration
Teeing grounds were verti-drained
using ½” diameter tines while the semi roughs to the 6th hole were
verti-drained with 1” diameter tines fitted.
Fairways were slit-tined to a depth of 4” with the Ryan Renovaire
aerator.
Miscellaneous
Miscellaneous jobs carried out
during the month included screening sand, spreading salt round the Starters’
Box, car park and service roads, cut and roll greens, blow pine needles from
the 3rd, 5th and 16th greens and place new,
mobile framed tee mats at the 9th, 14th and 16th
tees.
BUDDON LINKS COURSE
Bunker Revetments
Bunkers revetted during the month
included :-
7th greenside (3)
9th greenside (2)
Drainage Works and Ditch
Clearance
The concentration of course work
during December was on drainage installation and ditch base excavation to
improve water flows.
Ditches bases on the 5th,
6th and 12th holes were lowered to suit appropriate runs
using a laser, while trenches were excavated for wavin-coil drainage-pipe installation
across the 10th approach and southwards to run into the ditch behind
the 13th green; across the front and across the rear of the 9th
green, both of which were connected to the previous 6” main pipe installation
running down through the trees to the left of the 7th hole and on
alongside the 8th tee.
Miscellaneous
Miscellaneous jobs carried out
included; shaping sand in bunkers, building tee-mat frames, blowing debris from
certain greens and cutting and rolling greens.
Environmental Work
Gorse was cut back around the 1st
and 15th greens; right hand side of the 7th and 9th
holes; left hand side of the 8th; the 12th carry; around
the 12th and 17th greens; at the 5th tee and
right hand side of the 6th hole and left hand side of the 12th
all on the Championship Course. Broom
growth was strimmed close to ground level in heather banks on the 8th.
9th, 10th, 12th, 14th and 15th
holes on the Burnside Course.
A number of trees were blown down
on both the 8th and 28th of the month. These included three to the left of the 9th
hole and three behind the 9th green / 10th tee as well as
a large branch from a pine behind the 13th green, all on the
Championship Course. Several fallen
trees were cut up to the left of the 16th hole on the Burnside
Course while fallen trees on the 6th and 7th holes of the
Buddon Course were cut up and removed also.
Lower limbs of birch trees on the 7th hole along with
degenerate gorse behind the 8th tee were removed on this
course. All arisings from such work were
chipped or logged in the usual manner.
John S. Philp
Links Superintendent
